Resúmenes
| • Ensayos reportados para otros 17 pozos de perforación para 5.556m de perforación diamantina. | |
| • Los resultados recibidos son consistentes y confirman la mineralización en las áreas objetivo con leyes de Cu en línea y, en algunos casos, por encima de la estimación promedio de recursos minerales («MRE»): | |
| • Las mejores intercepciones recibidas son las siguientes: | |
| • HM96: | 40m @ 0.37% Cu (4 a 44m) |
| 116 m @ 0,36 % de Cu (228 a 344 m) | |
| • HM76: | 50m @ 0.33% Cu (102 a 152m) |
| 7m @ 0.37% Cu (216 a 223m) | |
| • HM78: | 36m @ 0.33% Cu (86 a 122m) |
| • HM79: | 96m @ 0.31% Cu (74 a 170m) |
| • HM81: | 12m @ 0.49% Cu (182 a 194m) |
| • HM83: | 34m @ 0.35% Cu (10 a 44m) |
| • HM84: | 38m @ 0.33% Cu (4 a 42m) |
| • HM86: | 30m @ 0.33% Cu (68 a 98m) |
| 92m @ 0.32% Cu (252 a 344m) | |
| • HM91: | 52m @ 0.36% Cu (18 a 70m) |
| 46m @ 0.34% Cu (126 a 172m) | |
| • HM100: | 30m @ 0.33% Cu (180 a 210m) |
| 10m @ 0.48% Cu (374 a 384m) | |
| • Cuatro equipos portátiles adicionales han llegado a Namibia y están en tránsito hacia el sitio y comenzarán a perforar en octubre, lo que eleva el número total de equipos a ocho equipos en el programa de perforación de recursos y 2 equipos en perforación Geotech. | |
| • Se completó el registro y la interpretación geológica centrada en la litología, la estructura y el modelado de los subproductos de Mo y Au y actualmente se está utilizando para modelos actualizados. | |
Koryx Copper Inc. («Koryx» o la «Compañía«) (TSX-V: KRY) se complace en anunciar los resultados de los ensayos de 17 pozos de perforación (5.556 m) recibidos como parte del programa de perforación de Fase 2 y 3 para su estrategia de exploración y desarrollo de proyectos para 2025 en el Proyecto de Cobre Haib de propiedad total («Haib» o el «Proyecto«) en el sur de Namibia. Haib es un proyecto de Cu/Mo/Au en etapa avanzada que se prevé para producir un concentrado de cobre a través de un proceso metalúrgico convencional de trituración/molienda/flotación, con el potencial de una producción adicional de cobre a través de la lixiviación en pilas.
Heye Daun, presidente y director ejecutivo de Koryx Copper, comentó: «El reciente lote de 17 resultados de ensayos representa una buena distribución de ubicaciones en todo el sistema mineralizado y en cada una de las cuatro áreas objetivo definidas. Es alentador que los pozos continúen arrojando resultados positivos consistentes y apoyen el recurso mineral en Haib. El equipo geológico del sitio ha logrado un progreso notable en la construcción de un modelo geológico actualizado, habiendo completado el reregistro de todos los núcleos de perforación disponibles, actualizado la base de datos y, bajo la guía de nuestros consultores expertos, ha reinterpretado todo el modelo litológico y estructural del depósito.
Ahora estamos integrando toda esta información y con este modelo geológico actualizado ahora tenemos una comprensión mucho mejor de los controles y la distribución de la ley de cobre y molibdeno. El nuevo modelo también permite a los geólogos mejorar y estimar con mayor precisión el recurso mineral general. Estos modelos actualizados se están revisando actualmente con la intención de actualizar y publicar el MRE actualizado antes de finales de 2025, con el objetivo de obtener el lado positivo de los resultados de perforación recibidos desde la estimación anterior en agosto de 2024″.

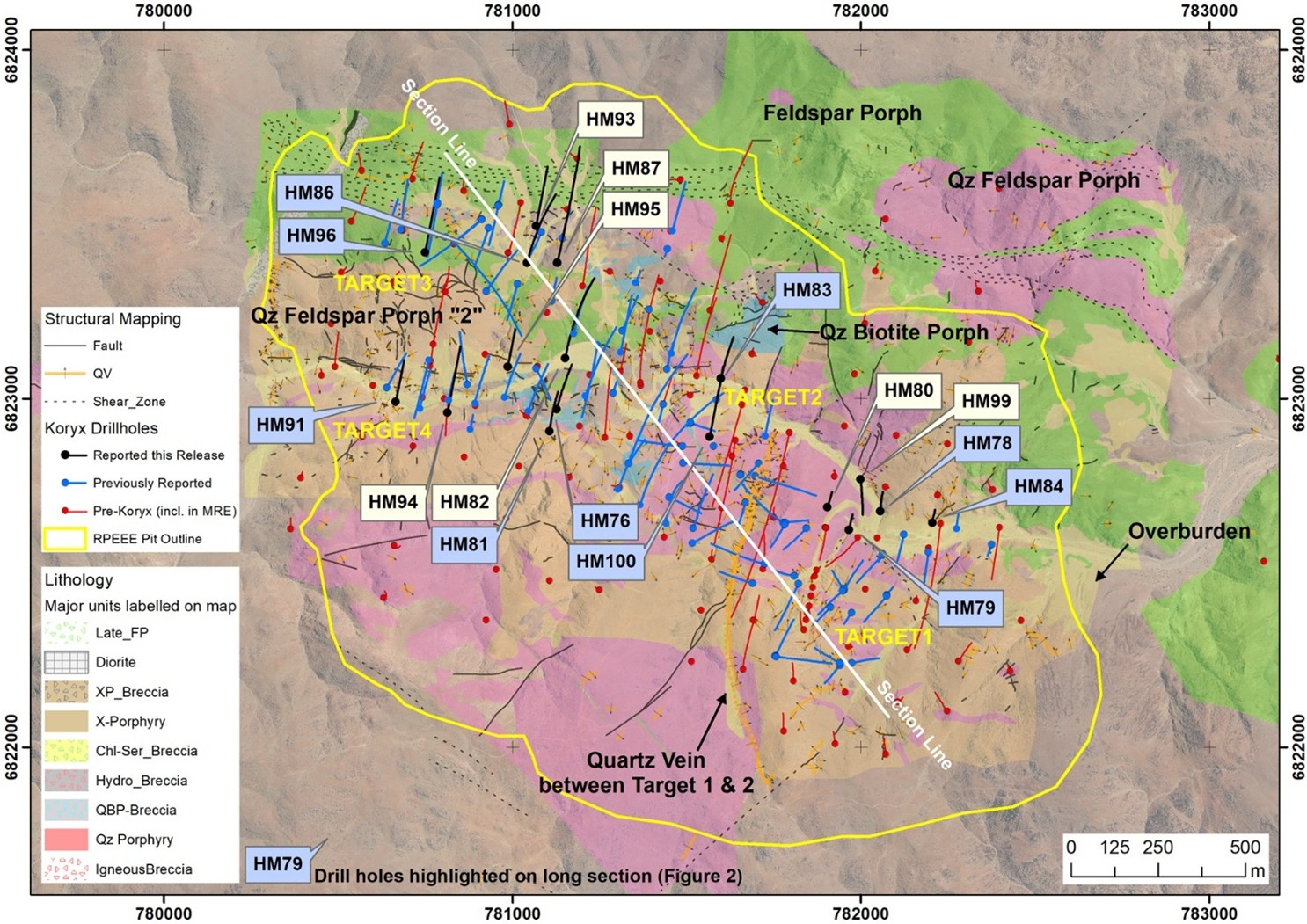

Figura 1: Vista en planta que indica las diecisiete ubicaciones recientes de los pozos de perforación. Los agujeros indicados en azul se muestran en la sección larga a continuación

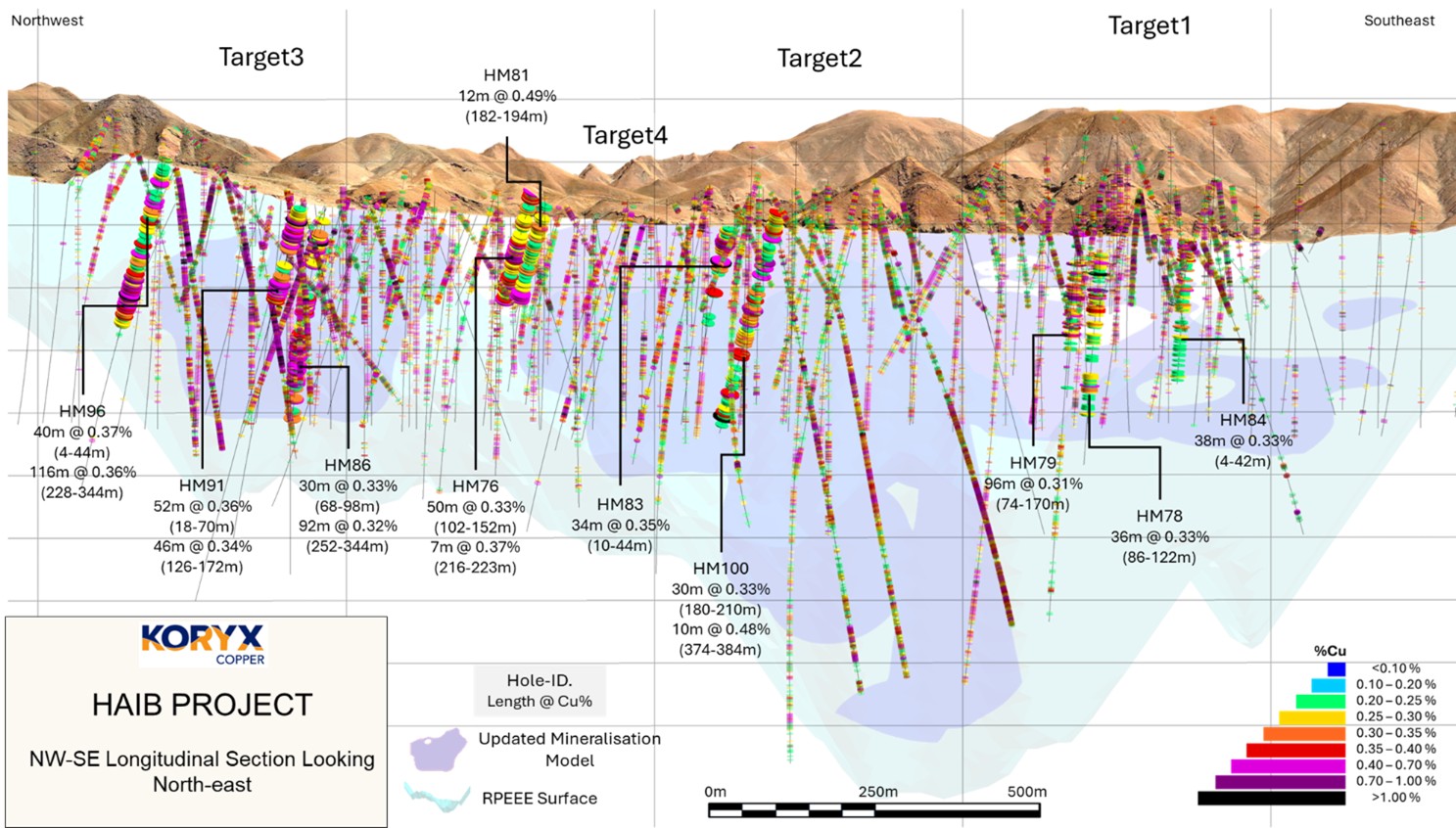

Figura 2. Sección larga mirando hacia el noreste que muestra diez pozos seleccionados de las 17 intersecciones de pozos reportadas en relación con el modelo de mineralización de Cu
Discusión de los resultados de la perforación
Resultados de la Meta 1:
Los resultados recientes en la Meta 1 han refinado aún más el modelo de mineralización. HM78 y HM79, perforados hacia el norte desde el río Volstruis, confirmaron la mineralización de cobre con buzamiento poco profundo con resultados consistentes con las expectativas. Sin embargo, HM99, perforado al norte de HM79 en la misma línea de sección, arrojó leyes más bajas, lo que indica que la mineralización no se extiende tan al norte como se modeló anteriormente, probablemente debido a una falla no reconocida. HM80, ubicado a 40 m al oeste de HM79, confirmó el estrechamiento esperado de la mineralización cerca del límite de la veta de cuarzo con el objetivo 2, mostrando que ocurre más al sur de lo previsto y sugiriendo una pequeña reducción en el tonelaje. HM84, perforado a 150 m al este de HM78, cerró con éxito el espaciamiento de muestras y entregó resultados en línea con el modelo actual, fortaleciendo la confianza en la continuidad.
Resultados de la Meta 2
La perforación en el Objetivo 2 continúa confirmando una fuerte mineralización de cobre. HM83, perforado hacia el norte desde el río Volstruis, delineó el límite norte de la zona con 34 m de cobre cerca de la superficie bien desarrollado, incluidos 8 m a 0,64% Cu, y un segundo intervalo mineralizado de 64 m a 80 m. Las leyes disminuyen por debajo de los 80 m, lo que ayuda a definir la profundidad de la mineralización en esta área. HM100, perforado centralmente, cerró con éxito el espaciado y arrojó resultados en línea con las expectativas, fortaleciendo aún más la confianza en la continuidad en todo el objetivo.
Resultados de la Meta 3
La perforación en el Objetivo 3 ha proporcionado una mayor definición de los controles y límites de mineralización. HM86, perforado cerca del borde noreste, confirmó el cobre dentro de las andesitas porfídicas, con leyes que aumentan a una profundidad menor de lo previsto por el modelo. HM87, ubicada a 90 m al este de HM86 donde el Objetivo 3 se superpone con el Objetivo 2, arrojó leyes más bajas de lo esperado, con la zona amplia anticipada de >0.2% Cu ausente, probablemente debido a fallas o un cambio local en el buzamiento hacia el noreste. HM93, perforado a lo largo del borde norte, refinó la posición de la zona de cizallamiento que define el límite de mineralización, mostrando que está ligeramente más al sur de lo modelado. HM96, perforado en el oeste, cerró con éxito el espaciamiento en esta área con resultados consistentes con las expectativas, fortaleciendo la confianza en la continuidad.
Resultados de la Meta 4
La perforación en el Objetivo 4 ha confirmado extensiones de mineralización y ha resaltado áreas de posible ganancia de tonelaje. HM76, perforado entre los objetivos 2 y 4 a lo largo del río Volstruis, interceptó una fuerte mineralización de cobre y molibdeno, incluidos >200 ppm Mo en 160 m con múltiples muestras que superaron las 2.000 ppm. HM81, con buzamiento perforado, se correlacionó bien con HM76 en profundidad, lo que confirma la continuidad de las zonas de Cu-Mo más profundas. HM82, perforado al norte de HM76 a través de la estructura del río, arrojó leyes bajas cerca de la superficie, pero mostró un aumento de cobre y molibdeno de alta ley disperso en profundidad. Los pozos de relleno HM91 y HM94, perforados en el centro del objetivo, generalmente se alinearon con el modelo, aunque HM91 reveló una zona de 46 m con un promedio de 0,34% Cu fuera del dominio actual de alta ley, lo que indica una mineralización más amplia de lo esperado, mientras que HM94 arrojó un cobre ligeramente inferior al previsto debido al dominio de la andesita porfídica en lugar de la brecha, que es más típica aquí. HM95, en el borde este, interceptó zonas de cobre más profundas más allá del modelo, lo que representa un aumento potencial del tonelaje.
Tabla de intersecciones significativas
| Agujero# | Zona | Desde (m) | A (m) | Ancho (m)1 | Cu (%) | Mes (%) | Au (g/t) |
| HM76 | Agujero entero | 1 | 223 | 221 | 0.24 | 0.015 | 0.017 |
| Principal | 1 | 22 | 21 | 0.34 | 0.004 | 0.016 | |
| Principal | 102 | 152 | 50 | 0.33 | 0.022 | 0.024 | |
| Incluido | 124 | 136 | 12 | 0.47 | 0.062 | 0.029 | |
| Principal | 174 | 202 | 28 | 0.31 | 0.013 | 0.018 | |
| Principal | 216 | 223 | 7 | 0.37 | 0.005 | 0.03 | |
| HM78 | Agujero entero | 0 | 369 | 369 | 0.21 | 0.001 | 0.026 |
| Principal | 60 | 62 | 2 | 3.75 | 0.002 | 0.184 | |
| Principal | 86 | 122 | 36 | 0.33 | 0.001 | 0.039 | |
| Principal | 240 | 250 | 10 | 0.31 | 0.004 | 0.041 | |
| HM79 | Agujero entero | 0 | 270 | 270 | 0.2 | 0.001 | 0.03 |
| Principal | 2 | 6 | 4 | 0.55 | 0.004 | 0.026 | |
| Principal | 74 | 170 | 96 | 0.31 | 0.002 | 0.044 | |
| Incluido | 102 | 110 | 8 | 0.78 | 0.011 | 0.057 | |
| HM80 | Agujero entero | 0 | 260 | 260 | 0.14 | 0.001 | 0.027 |
| Principal | 0 | 14 | 14 | 0.36 | 0 | 0.068 | |
| HM81 | Agujero entero | 0 | 220 | 220 | 0.19 | 0.012 | 0.015 |
| Principal | 182 | 194 | 12 | 0.49 | 0.011 | 0.033 | |
| HM82 | Agujero entero | 0 | 506 | 506 | 0.12 | 0.004 | 0.016 |
| Principal | 206 | 212 | 6 | 0.41 | 0.004 | 0.028 | |
| Principal | 250 | 268 | 18 | 0.31 | 0.01 | 0.035 | |
| HM83 | Agujero entero | 0 | 195 | 195 | 0.19 | 0.001 | 0.011 |
| Principal | 10 | 44 | 34 | 0.35 | 0.002 | 0.017 | |
| Incluido | 28 | 36 | 8 | 0.64 | 0.005 | 0.026 | |
| Principal | 64 | 80 | 16 | 0.41 | 0.002 | 0.019 | |
| HM84 | Agujero entero | 0 | 240 | 240 | 0.23 | 0.002 | 0.024 |
| Principal | 4 | 42 | 38 | 0.33 | 0.001 | 0.034 | |
| Incluido | 12 | 20 | 8 | 0.46 | 0.002 | 0.043 | |
| Principal | 82 | 88 | 6 | 0.37 | 0.001 | 0.035 | |
| HM86 | Agujero entero | 0 | 425 | 425 | 0.19 | 0.001 | 0.017 |
| Principal | 68 | 98 | 30 | 0.33 | 0.002 | 0.03 | |
| Incluido | 76 | 82 | 6 | 0.62 | 0.004 | 0.073 | |
| Incluido | 94 | 96 | 2 | 0.58 | 0.002 | 0.032 | |
| Principal | 184 | 216 | 32 | 0.3 | 0.001 | 0.028 | |
| Incluido | 214 | 216 | 2 | 0.59 | 0.003 | 0.033 | |
| Principal | 252 | 344 | 92 | 0.32 | 0.002 | 0.021 | |
| HM87 | Agujero entero | 0 | 615 | 615 | 0.09 | 0.001 | 0.025 |
| HM91 | Agujero entero | 0 | 246 | 246 | 0.2 | 0.002 | 0.017 |
| Principal | 18 | 70 | 52 | 0.36 | 0.005 | 0.019 | |
| Incluido | 20 | 26 | 6 | 0.69 | 0.002 | 0.02 | |
| Incluido | 46 | 58 | 12 | 0.61 | 0.001 | 0.018 | |
| Principal | 126 | 172 | 46 | 0.34 | 0.004 | 0.019 | |
| HM93 | Agujero entero | 0 | 320 | 320 | 0.08 | 0.001 | 0.01 |
| Principal | 106 | 116 | 10 | 0.3 | 0.001 | 0.009 | |
| HM94 | Agujero entero | 0 | 389 | 389 | 0.14 | 0.008 | 0.014 |
| Principal | 148 | 166 | 18 | 0.32 | 0.044 | 0.014 | |
| HM95 | Agujero entero | 0 | 223 | 223 | 0.2 | 0.005 | 0.01 |
| Principal | 20 | 26 | 6 | 0.56 | 0.001 | 0.031 | |
| Principal | 38 | 48 | 10 | 0.31 | 0.001 | 0.016 | |
| Principal | 168 | 174 | 6 | 0.31 | 0.016 | 0.003 | |
| Principal | 202 | 223 | 21 | 0.31 | 0.014 | 0.011 | |
| HM96 | Agujero entero | 0 | 441 | 441 | 0.22 | 0.003 | 0.013 |
| Principal | 4 | 44 | 40 | 0.37 | 0.005 | 0.017 | |
| Incluido | 12 | 18 | 6 | 0.51 | 0.007 | 0.019 | |
| Incluido | 34 | 40 | 6 | 0.61 | 0.002 | 0.028 | |
| Principal | 228 | 344 | 116 | 0.36 | 0.004 | 0.02 | |
| Incluido | 270 | 276 | 6 | 0.57 | 0.001 | 0.036 | |
| Incluido | 282 | 290 | 8 | 0.54 | 0.002 | 0.027 | |
| Incluido | 302 | 308 | 6 | 1.27 | 0.006 | 0.041 | |
| HM99 | Agujero entero | 0 | 202 | 201 | 0.16 | 0.002 | 0.047 |
| Principal | 130 | 132 | 2 | 2.09 | 0.027 | 0.027 | |
| Principal | 168 | 170 | 2 | 0.91 | 0.016 | 0.069 | |
| HM100 | Agujero entero | 2 | 413 | 411 | 0.21 | 0.004 | 0.014 |
| Principal | 180 | 210 | 30 | 0.33 | 0.007 | 0.022 | |
| Incluido | 182 | 186 | 4 | 0.66 | 0.016 | 0.027 | |
| Principal | 338 | 346 | 8 | 0.3 | 0.001 | 0.019 | |
| Principal | 374 | 384 | 10 | 0.48 | 0.008 | 0.029 | |
| Incluido | 382 | 384 | 2 | 1.27 | 0.028 | 0.072 |
- Los anchos son anchos de intervalo y no anchos verdaderos. Los intervalos notificados se calculan utilizando los siguientes parámetros:
- Solo se utilizó % Cuse para determinar los intervalos
- El grado compuesto objetivo es ≥0,30% Cu.
- Los compuestos comienzan y terminan con muestras ≥0,30% Cu.
- Las calificaciones entre 0.20% y 0.30% se incluyen en el intervalo, pero generalmente constituyen <40% del intervalo.
- Las muestras consecutivas entre 0,20% y 0,30% deben ser inferiores a 5 muestras (10m).
- Se incluyen las pendientes inferiores al 0,20%, pero generalmente constituyen el <20% del intervalo.
- Las leyes consecutivas <0,2% deben ser inferiores a 2 muestras (4 m).
Actualización de Resource Modelling
El gran lote de resultados reportados anteriormente ha sido extremadamente útil para proporcionar la información para definir aún más la complejidad estructural del sistema, así como para actualizar los modelos litológicos y de mineralización, particularmente en áreas donde se han encontrado fallas significativas. El conjunto completo de ensayos multielemento y ensayos de oro se ha agregado a la base de datos para su revisión y análisis estadístico durante el resto de octubre, con la intención de producir un MRE actualizado para fin de año.
Se espera que la actualización de MRE demuestre el lado positivo de las exitosas campañas de perforación en el recurso de cobre y el aumento significativo en el número de ensayos de molibdeno para estimación, así como la posible inclusión de oro por primera vez como un modelo discreto.
También se espera que el aumento de la densidad de los resultados de perforación en todas las áreas del sistema mineralizado mejore la clasificación de recursos en el nuevo modelo de bloques al convertir el material inferido a la categoría indicada. El equipo espera que con una mejor comprensión del material inferido que se espera que permanezca después de la actualización, se pueda desarrollar un plan de perforación detallado para apuntar a convertir el recurso a la categoría indicada en preparación para la publicación del estudio de prefactibilidad en 2026.
Si bien el registro y la interpretación del núcleo utilizados para actualizar los nuevos modelos geológicos y MRE ayudarán a guiar la planificación futura de la perforación en las diferentes áreas de Target, con la llegada de cuatro nuevas plataformas de perforación en octubre, el equipo espera acelerar el programa de perforación para ejecutar el programa restante en la primera mitad de 2026.
Emisión de RSU
La Compañía ha aprobado la concesión de hasta un total de 4,135,000 unidades de acciones restringidas (cada una, una «RSU») a ciertos ejecutivos, funcionarios, consultores y directores clave de la Compañía de conformidad con el Plan Ómnibus de la Compañía, de los cuales 1/2 de las RSU se otorgarán 12 meses a partir de la fecha de emisión, y luego una cuarta parte después de 18 y 24 meses. Cada RSU representa el derecho a recibir, una vez adquirida, una acción ordinaria en el capital de la Compañía por cada RSU poseída, o el equivalente en efectivo de la misma en función del valor justo de mercado de las acciones de la Compañía calculado de acuerdo con los términos del Plan Ómnibus.
La concesión de RSU está sujeta a las aprobaciones y requisitos regulatorios necesarios de la Bolsa.
Control de calidad
Todo el núcleo de perforación fue registrado, fotografiado y cortado por la mitad con una sierra de diamante. La mitad del núcleo se embolsó y se envió a ALS Laboratories Ltd. en Johannesburgo, Sudáfrica para su análisis (Laboratorio de pruebas acreditado por SANAS, No. T0387) y ActLabs en Canadá, mientras que la otra mitad se almacenó en cuartos con una cuarta parte archivada y almacenada en el sitio con fines de verificación y referencia, mientras que la otra cuarta parte se utilizará para trabajos de pruebas metalúrgicas. Se analizan 33 elementos mediante plasma acoplado inducido (ICP) utilizando una digestión de 4 ácidos y se analiza el oro mediante un método de ensayo al fuego de 30 g. Las muestras duplicadas, los espacios en blanco y los estándares certificados se incluyen con cada lote y se utilizan activamente para garantizar una garantía de calidad adecuada y un control de calidad («QA / QC«) La frecuencia de QA / QC es de 1 en 20 para cada uno de los espacios en blanco, duplicados y estándares.
Persona calificada
El Sr. Dean Richards Pr.Sci.Nat., MGSSA – BSc. (Hons) Geology es la Persona Calificada para el Proyecto de Cobre Haib y ha revisado y aprobado la información científica y técnica en este comunicado de prensa y es un Científico Natural Profesional registrado en el Consejo Sudafricano de Profesiones Científicas Naturales (Pr. Sci. Nat. No. 400190/08).
Acerca de Koryx Copper Inc.
Koryx Copper Inc. es una empresa canadiense de desarrollo de cobre centrada en el avance del proyecto de cobre Haib en Namibia, al tiempo que construye una cartera de licencias de exploración de cobre en Zambia. Haib es un depósito de pórfido de cobre/molibdeno grande y avanzado (etapa PEA) en el sur de Namibia con una larga historia de exploración y desarrollo de proyectos por parte de múltiples operadores. Se han realizado más de 80.000 m de perforación en Haib desde la década de 1970 con importantes programas de exploración liderados por empresas como Falconbridge (1964), Rio Tinto (1975) y Teck (2014). Hasta la fecha, también se han completado extensas pruebas metalúrgicas y varios estudios técnicos en Haib.
Se están realizando estudios adicionales con el objetivo de demostrar que Haib es un futuro proyecto de cobre a cielo abierto de larga duración, bajo costo y bajo riesgo, con el potencial de una producción adicional de cobre a partir de la lixiviación en pilas. Haib tiene un recurso mineral actual de 511Mt @ 0.33% Cu y 51 ppm Mo para 1,668kt de cobre contenido y 25.9kt de Mo contenido en la categoría Indicada y 308.9Mt @ 0.31% Cu y 40 ppm Mo para 949Mt de cobre contenido y 12.4kt contenido Mo en la categoría Inferida (corte de 0.15% Cu).
La mineralización en Haib es típica de un depósito de pórfido de cobre y es uno de los pocos ejemplos de un depósito de pórfido de cobre del Paleoproterozoico en el mundo y uno de los dos únicos en el sur de África (ambos en Namibia). Debido a su antigüedad, el depósito ha sido sometido a múltiples eventos metamórficos y de deformación, pero aún conserva muchas de las características clásicas de mineralización y alteración típicas de estos depósitos. La mineralización es predominantemente calcopirita con bornita y calcocita menores presentes y solo minerales secundarios de cobre menores en la superficie debido al ambiente árido.
Más detalles del Proyecto de Cobre Haib están disponibles en el informe técnico correspondiente titulado «Informe Técnico NI 43-101 – Estimación de Recursos Minerales de Agosto de 2024 para el Proyecto de Cobre Haib, Namibia» con fecha efectiva del 31 de agosto de 2024 (el «Informe Técnico«). El Informe Técnico y otra información están disponibles en el sitio web de la Compañía en https://koryxcopper.com y en el perfil de la Compañía en SEDAR+ en www.sedarplus.ca.
